Client
MidCoast Christian College, Taree, NSW
Sector
Education
Year Completed
2024
Budget
-

MidCoast Christian School saw the benefits of using two storey modular construction to: - minimise the impact on school land area (not remove play space, or potential for new buildings) - support rapid growth in school population by delivering 8 new classrooms, administration office and amenities in one package - enhance learning opportunities with additional large open learning space and balcony - satisfy open circulation with wide corridors, lift and two open stairways - all prefabricated
Architecture Modular Manufacturer / Builder
Marathon Modular
Structural / DfMA Engineer

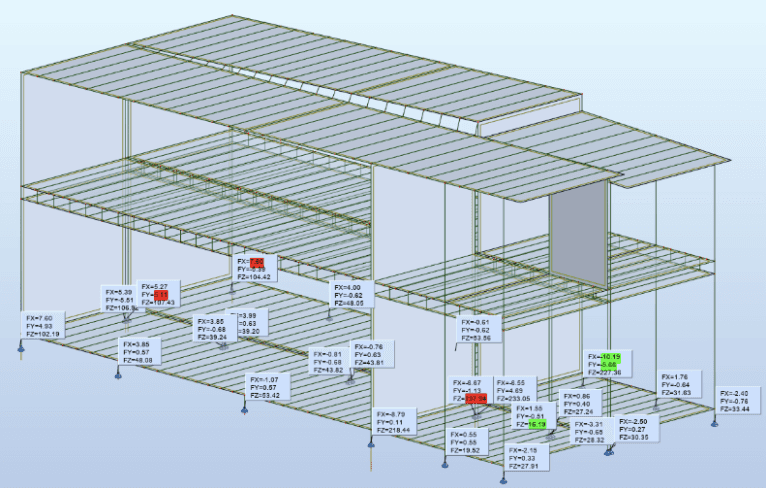

Simon McCarthy, Bryden Wood
Project Manager
-


Frame type
Volumetric Modular
Area
1,180sqm
Rise in Storeys
2
No. of Modules
22

Schedule
August 2023 - January, 2024
Design
4 months
Manufacture
4 months
Assembly

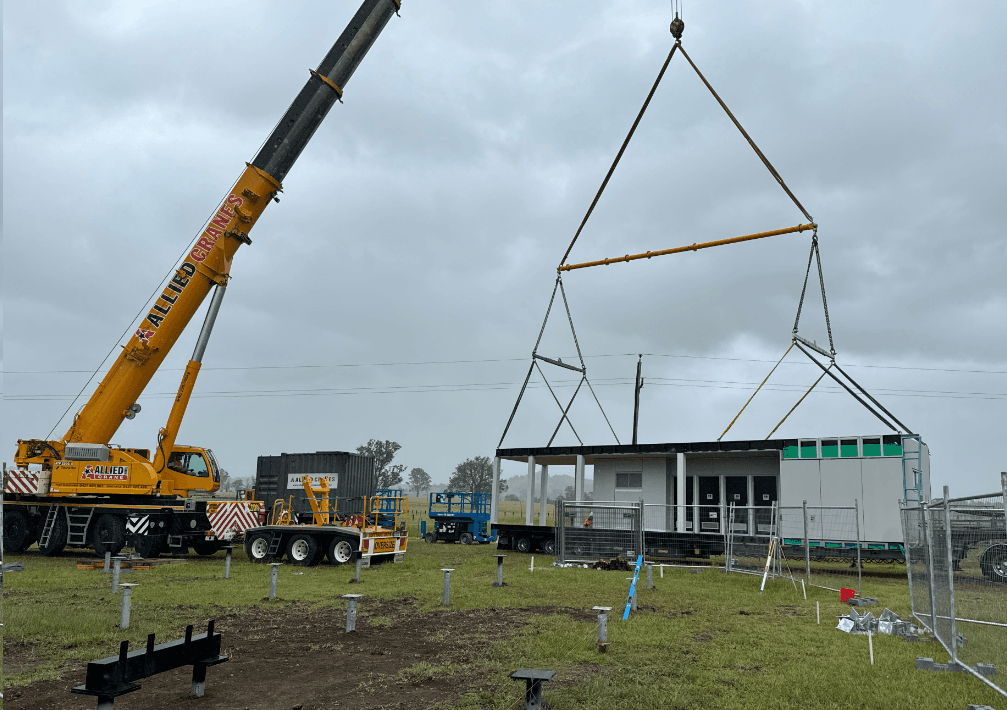

1 month
Distance From Factory
228km
